The 2026 Dynamics 365 Migration Handbook: Tools, Costs, and Step-by-Step Roadmap
Planning a Dynamics 365 migration? Get a transparent breakdown of 2026 cloud migration costs, the best ETL tools for CRM data, and a step-by-step roadmap to ensure zero data loss during your transition.
Planning a migration?
Get a free 30-min call with our engineers. We'll review your setup and map out a custom migration plan — no obligation.
Schedule a free call- 1,500+ migrations completed
- Zero downtime guaranteed
- Transparent, fixed pricing
- Project success responsibility
- Post-migration support included
With the Dynamics CRM 2016 (v8.2) end of life date occurring on January 13, 2026, IT departments are no longer debating the "if" of migration, but the "how". Transitioning a legacy database to the cloud is a high-stakes engineering task that involves significant data mapping, security considerations, and financial planning.
This handbook provides a technical roadmap for the Dynamics 365 migration from on-premise to cloud, detailing the tools available and the realistic costs associated with a 2026 transition.
Disclosure: ClonePartner is a migration service provider. We've done our best to present the tool landscape fairly, but our perspective is shaped by the work we do. Where we recommend our own services, we say so explicitly.
1. Step-by-Step Roadmap for Dynamics 365 Cloud Transition
To avoid common pitfalls in Dynamics CRM on-prem to online migration—such as data corruption, orphaned records, or broken security roles—a structured five-phase roadmap is essential.
Phase 1: Environment & API Connection
The migration begins by establishing a secure bridge between your local SQL environment and the Microsoft Power Platform.
- Security Standards: Use AES-256 encrypted API connections.
- Authentication: Plan for the shift from on-premises Active Directory to Azure AD (now Microsoft Entra ID). This affects user provisioning, service accounts, and any integrations that rely on Windows Authentication or on-prem AD groups.
- Compliance: Ensure the destination environment meets your industry's specific standards (GDPR, HIPAA, or SOC 2) before initiating transfer.
Phase 2: Technical Audit & Pre-Migration Checklist
Before moving data, a thorough audit of your "technical debt" is required.
- Clean Data: Identify and archive duplicate records or obsolete logs to prevent cloud storage bloat.
- Schema Verification: Check for custom entities or plugins from 2016 that may not be compatible with modern Dataverse. Common breaking points include deprecated SDK methods (e.g.,
OrganizationServiceProxyreplaced byServiceClient), removed web resource types, and classic workflows that need conversion to Power Automate flows. - Plugin & Custom Code Review: Audit all registered plugin assemblies and custom workflow activities. Code targeting the CRM 2016 SDK may reference deprecated namespaces or use patterns incompatible with Dataverse's execution sandbox.
- SSRS Reports: On-premises SSRS reports do not transfer directly to Dynamics 365 Online. Plan to rebuild these using Power BI, paginated reports in Power BI, or Dataverse-native reporting.
- Power Platform Dependency Mapping: Identify any Power Automate flows, canvas apps, or model-driven apps that connect to your on-prem environment. These will need reconfigured data sources and potentially new connectors.
- Fallback Planning: Establish a "rollback" procedure in case the final cutover encounters unexpected API failures.
Phase 3: Pilot/Sample Migration
Run a test migration using a representative sample (approx. 5–10%) of your data. This phase is used to verify mapping accuracy, test user permissions, and identify "orphaned" data that lost its parent-child relationships during the move.
Phase 4: Full Cutover
Execute the complete transfer of all active records to Microsoft Dynamics 365 Sales.
- Timing: This usually occurs over a weekend to minimize business impact.
- Logging: Ensure real-time logging is active to catch and re-process any failed records immediately.
Phase 5: Delta Synchronization
Since business continues during the migration window, a "Delta Migration" is often used to sync any records created or updated between the start of Phase 4 and the final go-live. This ensures 100% data parity.
2. 2026 Tool Categories: What Software Should You Use?
Choosing the right approach depends on your database size, the complexity of your custom code, and your internal engineering capacity. Below is a breakdown of the primary methods used for Dynamics migrations in 2026:
| Tool Category | Options | Best For | Key Trade-offs |
|---|---|---|---|
| Specialized Service Provider | ClonePartner, Hitachi Solutions, Avanade, other Dynamics partners | Organizations requiring an end-to-end managed transition with dedicated engineer support. | Higher upfront cost; less internal knowledge transfer. |
| High-Volume ETL | KingswaySoft / SSIS, Dataflows | Complex environments requiring deep data transformation and field mapping. | Powerful but requires SSIS expertise; steep learning curve. |
| Cloud-Native | Azure Data Factory (ADF), Azure Synapse | High-speed migration for massive SQL databases moving directly into Dataverse. | Excellent throughput; requires Azure skills and careful connector configuration. |
| No-Code Integration | Power Automate, third-party iPaaS tools | Mid-market users who prefer a visual mapping interface over code. | Accessible but can hit performance limits at scale. |
| Microsoft Native | Microsoft AIM | The official framework for structured, policy-aligned cloud shifts. | Structured approach; may require Microsoft engagement and qualification. |
Note on Scribe Online (TIBCO): Scribe Online has been deprecated by TIBCO. If you were planning to use it, evaluate current alternatives like KingswaySoft, Power Automate, or Azure Data Factory instead.

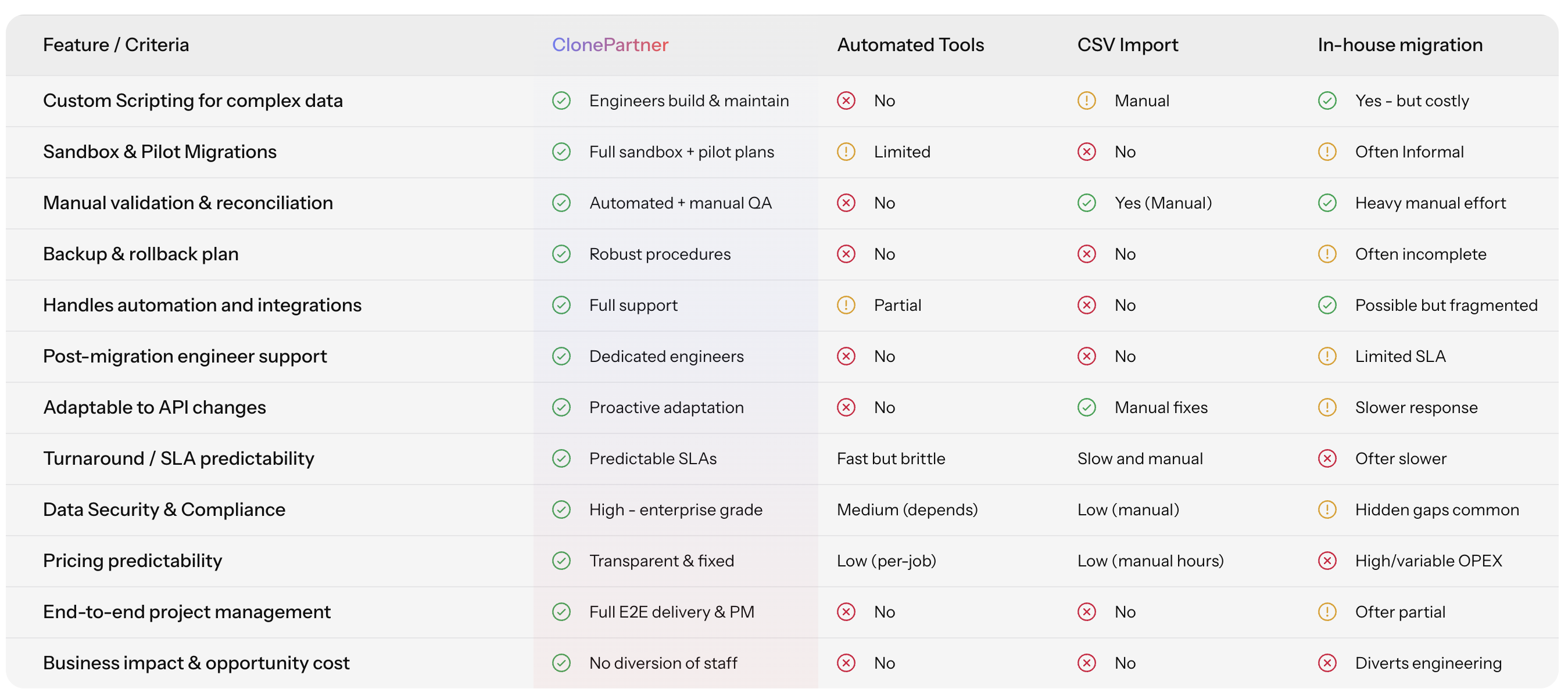

Comparison of Migration Methods
To help compare the trade-offs between speed, cost, and reliability across these categories:
| Criteria | In-House / Manual | ETL Tools (KingswaySoft, ADF) | Managed Service Provider |
|---|---|---|---|
| Predictability | Variable — depends on internal capacity and competing priorities | Moderate — tooling is reliable but requires skilled operators | High — fixed scope, timeline, and pricing |
| Security | Depends on internal security posture | Depends on configuration and environment setup | Typically SOC 2 / GDPR certified, but verify per provider |
| Engineering Impact | High — diverts internal staff from core work | Moderate — requires dedicated ETL engineers | Low — external team handles execution |
| Adaptability to API Changes | Slow — team must monitor and react | Moderate — tool updates may lag | Fast — dedicated engineers track changes proactively |
| Cost | Lower direct cost; higher risk of overruns | Mid-range; licensing + internal labor | Higher upfront; more predictable total cost |
3. Financial Breakdown: Cloud Migration Costs in 2026
Understanding dynamics 365 on-premise vs online cost 2026 requires a look at both direct and indirect expenses.
Licensing Costs
Microsoft publishes Dynamics 365 pricing on their pricing overview page. Key tiers as of early 2026:
- Dynamics 365 Sales Professional: $65/user/month
- Dynamics 365 Sales Enterprise: $105/user/month
- Dynamics 365 Sales Premium: $150/user/month
Verify current pricing directly with Microsoft, as these may change.
Dataverse Storage Costs
Dataverse charges for storage across three categories, and this catches many teams off guard:
- Database storage: Structured data (records, metadata)
- File storage: Attachments, documents, images
- Log storage: Audit logs, plugin trace logs
Each tenant gets a base allocation included with licenses. Overages are billed per GB. Archiving outdated data before the move can meaningfully reduce recurring monthly storage costs.
Implementation Costs
A commonly cited industry ratio is 3:1 — for every $1 spent on licenses, expect to spend roughly $3 on implementation and data cleanup. This varies significantly based on customization complexity, data volume, and the number of integrations.
Microsoft Incentives
The Bridge to the Cloud 2 promotion offers licensing discounts for customers moving from end-of-life on-premises versions. Eligibility and discount percentages depend on your current licensing agreement and the target Dynamics 365 product. Contact your Microsoft account representative or licensing partner for specific terms.
Timeline
How long does it take to migrate from Dynamics 365 on-premises to cloud?
Timeline depends on data volume, entity complexity, custom code, and integration count. As rough benchmarks:
- Simple migration (out-of-the-box entities, under 100K records, minimal customization): days to a couple of weeks.
- Mid-complexity (custom entities, plugins, integrations, 100K–1M records): 4–8 weeks.
- High-complexity (heavy customization, multiple integrations, millions of records, regulatory requirements): 2–4+ months.
These are directional — every environment is different. We scope timelines based on a technical assessment of your specific environment.
4. Version-Specific Migration Considerations
Not all on-premises migrations are the same. The version you're migrating from affects the scope of work:
- Dynamics CRM 2016 (v8.2): End of support January 13, 2026. May use deprecated SDK patterns, classic workflows, and SSRS reports that require rework. The largest gap between this version and modern Dataverse.
- Dynamics CRM 2015 and earlier: Similar challenges to CRM 2016, with the added complication that some customizations may rely on even older APIs. Data export may require intermediate transformation steps.
- Dynamics 365 v9.x on-premises: Closer to the online version in terms of SDK and entity model. Migration is typically less disruptive, but on-prem-specific configurations (IFD, ADFS) still need to be retired and replaced with cloud authentication.
The further back your version, the more custom code remediation and schema mapping you should expect.
5. Strategic Choice: In-House vs. Outsourced
The Dynamics CRM 2016 support deadline leaves little room for trial and error. Many teams find that the time saved by using a specialized methodology results in a lower total project cost than a prolonged in-house attempt — but this depends on your internal team's Dynamics and Dataverse expertise, available bandwidth, and risk tolerance.
Further Reading: In-House vs. Outsourced Data Migration: A 2026 ROI Analysis
Conclusion: Final 2026 Readiness
The dynamics 365 on-premises end of support 2026 is a hard cutoff. With the January 13th deadline nearly here, your priority should be securing your data through a validated technical roadmap.
Master Guide to Dynamics 365 End of Life Timeline
Post 1: Technical Risks of the Jan 13th Deadline
Post 2: NAV 2016 to Business Central Roadmap
Official Reference Links:
Frequently Asked Questions
- What are the benefits of migrating Dynamics CRM to the cloud vs staying on-prem?
- Beyond escaping the risks of legacy Dynamics CRM, the cloud offers automatic 99.9% uptime, built-in MFA security, and access to Microsoft Copilot for AI-driven sales summaries.
- Is Dynamics 365 Finance and Operations on-premises support ending soon?
- Support is active, but on-premises users are excluded from real-time AI features and "Generative Help" capabilities available in the online version.
- What happens to my data if I miss the Dynamics 365 support deadline?
- Your database remains intact, but you stop receiving all security patches. This creates an immediate risk of data breaches and may invalidate your cyber insurance.
